1998 MARS SURVEYOR PROJECT STATUS REPORT
November 22, 1998John McNamee
Mars Surveyor 98 Project ManagerMars Climate Orbiter: Launch -18 Days
Final closeout activities are progressing on schedule. Flight Sofware (FSW) patch 8.2.1.D was loaded and the spacecraft was powered down for the final time until the F-7 functional test on the Delta stack at SLC-17A on December 1.
Mars Polar Lander: Launch - 42 Days
The parachute and mortar were installed but final mate was not accomplished due to a mismatch between mortar and flight connector.
The Bonum spacecraft was launched on a Delta at 7:00 pm - this clears launch pad 17B for the lander - no other Delta launches occur before the Mars Climate Orbiter on December 10.
Time Lapse Movie
Mars Surveyor 98 Spacecraft At Kennedy Space Center
November 22, 1998
![]()

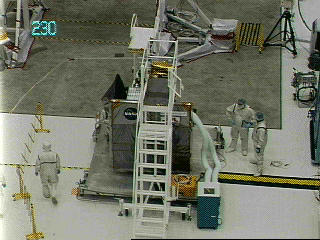

Mars Climate Orbiter
MPEG Movie - 332K![]()

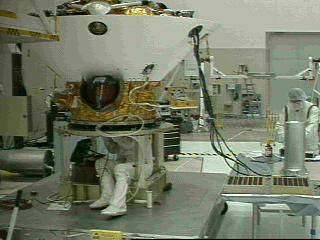

Mars Polar Lander
MPEG Movie - 1.4 MB
Need help in running animations? Look here for information on how to setup your browser for animations.
Home Mars Polar Lander Deep Space 2 Microprobes Mars Climate Orbiter Welcome Mailing List Links Credits For questions or comments on this website please refer to our list of contacts.
